Miya Bholat Miya Bholat

Sep 14, 2026


Key Takeaways

  1. Backlog is known unfinished maintenance. It covers identified work not yet completed.
  2. Labor hours matter more than counts. Open jobs can vary greatly in workload.
  3. SMRP commonly benchmarks ready backlog at 2 to 4 weeks. Total backlog is commonly cited at 4 to 6 weeks.
  4. Age changes risk. Old safety work can matter more than a larger fresh queue.
  5. Zero backlog can hide missing work. Defects or repairs may not be documented.
  6. Categories improve visibility. Separate PM, repairs, defects, parts holds, and follow up work.

What Is a Fleet Maintenance Backlog? A Working Definition

Fleet maintenance backlog means known work that has been identified, accepted, and not yet completed. The Society for Maintenance and Reliability Professionals defines ready backlog as work fully prepared for execution.

Industrial teams may keep backlog as a planned work buffer. Fleet queues often mix PM, repairs, driver defects, and waiting parts. Changes in those categories can appear as early signs of a growing maintenance backlog before downtime rises.

What Counts as Backlog (and What Doesn't)

Use the same boundary every week:

  • Include: overdue PM, approved open work orders, unresolved DVIR defects, parts hold work, and follow up work.
  • Exclude: work progressing within its allowed window, active repairs already being performed, and future PM not yet due.

Backlog vs. Deferred Maintenance vs. Reactive Work

The terms overlap but describe different states. APPA frames deferred maintenance as identified repairs and replacements that have been postponed, while reactive work interrupts the normal schedule.

Term Definition When it appears Typical risk
Backlog Identified approved work waiting for completion After a need is recorded Aging work and capacity pressure
Deferred maintenance Needed work postponed beyond when it should occur After required work is delayed Higher cost and deterioration
Reactive work Unplanned urgent work that bypasses the queue After an unexpected fault Downtime and schedule disruption

Heavy reactive demand can push planned work backward. Reactive fleet maintenance explains why backlog can grow even when technicians stay busy.

The 5 Types of Work That Make Up a Fleet Backlog

Most fleet backlogs contain five categories:

  • Overdue preventive maintenance: Service past its mileage, engine hour, or calendar interval.
  • Open work orders awaiting repair: Approved jobs not yet completed.
  • Unresolved driver inspection defects: DVIR findings still awaiting repair action.
  • Parts hold and vendor wait work: Jobs blocked by parts or outside service.
  • Follow up work from prior repairs: Remaining work from an incomplete earlier repair.

Mixing these categories into one count hides workload and risk.

How to Measure Fleet Maintenance Backlog

Work order counts can mislead because jobs vary in labor demand. Convert pending labor into weeks of technician capacity.

The Backlog Weeks Formula

Backlog Weeks = Total Estimated Labor Hours of Pending Work / Weekly Available Technician Hours

A fleet with 400 pending labor hours and 100 available technician hours per week has a 4 week backlog.

Use realistic capacity, not total paid hours. A planning model may reserve 20 to 30 percent for meetings, travel, administration, and interruptions, leaving 70 to 80 percent as planning capacity. That is not wrench time. SMRP defines wrench time more narrowly and cites about 50 to 55 percent as best in class.

Backlog Aging: The 0/30/60/90+ Day Buckets

Aging shows whether work is moving or becoming stale.

Age bucket Healthy pattern Growth can signal
0 to 7 days Healthy majority of new work Normal intake
8 to 30 days Normal working queue Scheduling friction if rising
31 to 90 days Small investigation zone Parts, labor, vendor, or ownership problems
90+ days Rare and individually reviewed Hidden deferral or stale records

A growing older bucket matters even when total backlog stays flat. The impact of delaying fleet maintenance for 30 days depends on repair type, vehicle role, and safety risk.

Ready to Schedule vs. Total Backlog

SMRP separates total backlog from ready backlog. Ready work has the planning, materials, tools, and information needed for execution. Practitioner guidance commonly cites 2 to 4 weeks ready and 4 to 6 weeks total.

A practical fleet target is to keep at least half of total backlog ready. Otherwise, technicians can wait despite a large queue.

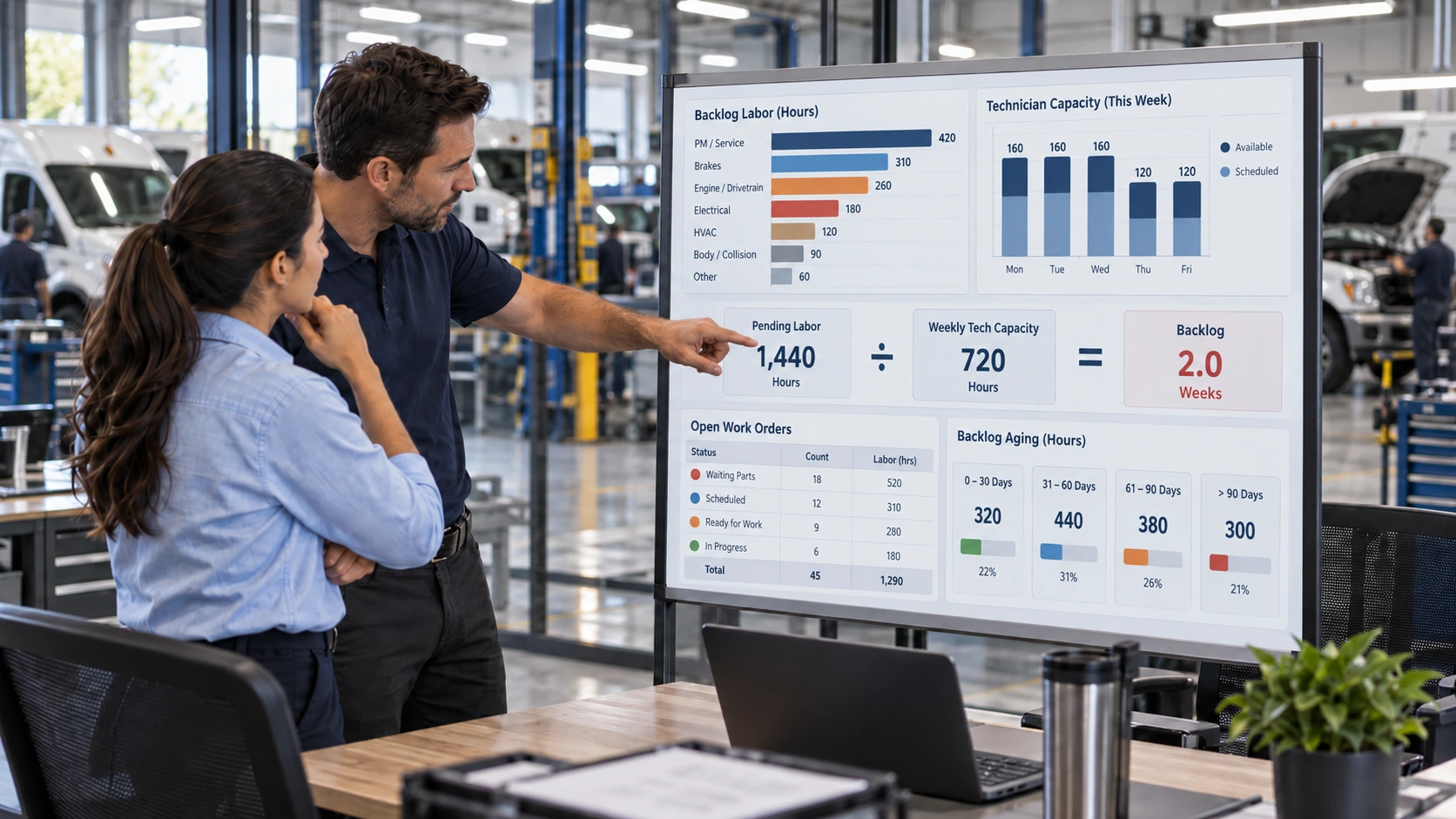

SMRP ready backlog benchmark range compared against a fleet's actual weekly queue

What a Healthy Fleet Backlog Actually Looks Like

A healthy backlog is neither empty nor uncontrolled. SMRP practitioners commonly cite 2 to 4 weeks of ready work. Below that, prepared work may be scarce. Above it, priority jobs can wait too long.

SMRP Benchmarks Applied to Fleet Operations

Fleet size changes the hours, not the ratio. A two technician shop and a 200 vehicle municipal fleet can both measure backlog in weeks.

Use this workflow weekly:

  1. Pull every open PM, work order, defect, and follow up item.
  2. Estimate labor hours using historical averages.
  3. Add the estimated hours.
  4. Divide by realistic weekly technician capacity.
  5. Compare ready backlog with the 2 to 4 week range and trend it over time.

SMRP practitioners commonly cite about 90 percent as a world class PM compliance goal. A City of San Diego fleet audit used the same 90 percent industry target for on time preventive maintenance.

Why Zero Backlog Is a Red Flag

Zero backlog can mean defects, technician work, or follow up repairs are not being recorded. That is missing visibility, not perfect maintenance.

Why Fleet Maintenance Backlog Matters

Backlog is a leading indicator because unresolved work accumulates before downtime, cost, or safety exposure becomes obvious. A 4 to 8 week trend can provide a planning window, not a fixed failure countdown.

The Financial Cost of an Uncontrolled Backlog

Delayed maintenance can become more expensive as conditions worsen. A City of San Diego audit used a conservative 7 percent annual increase for deferred maintenance. Because that estimate comes from facilities, fleets should treat it as a compounding cost warning, not a vehicle specific rate.

Recent industry reporting cites about $448 to $760 per vehicle per day in lost productivity from unplanned truck downtime. Actual cost varies by vehicle role, revenue, substitute equipment, driver time, and service disruption.

Small unresolved work can become larger repairs while downtime adds operating cost. Fleet downtime and maintenance causes help connect backlog age with vehicle availability.

Safety and Compliance Exposure

Safety critical backlog needs separate treatment. FMCSA requires carriers to correct defects that affect safe operation before dispatch. DVIR requirements cover brakes, steering, tires, wheels, lights, and coupling devices.

The FMCSA inspection and maintenance requirements provide the regulatory baseline for commercial motor vehicles.

How to Keep Fleet Backlog Visible and Under Control

Categorize PM, repairs, defects, parts holds, vendor work, and follow up jobs. Measure the queue in weeks, review it weekly, and review every item older than 90 days.

Use preventive maintenance schedules to identify services that cross mileage, hour, or date intervals before they disappear into a general repair list.

Each weekly review should confirm new work, aging work, ready work, and higher risk items.

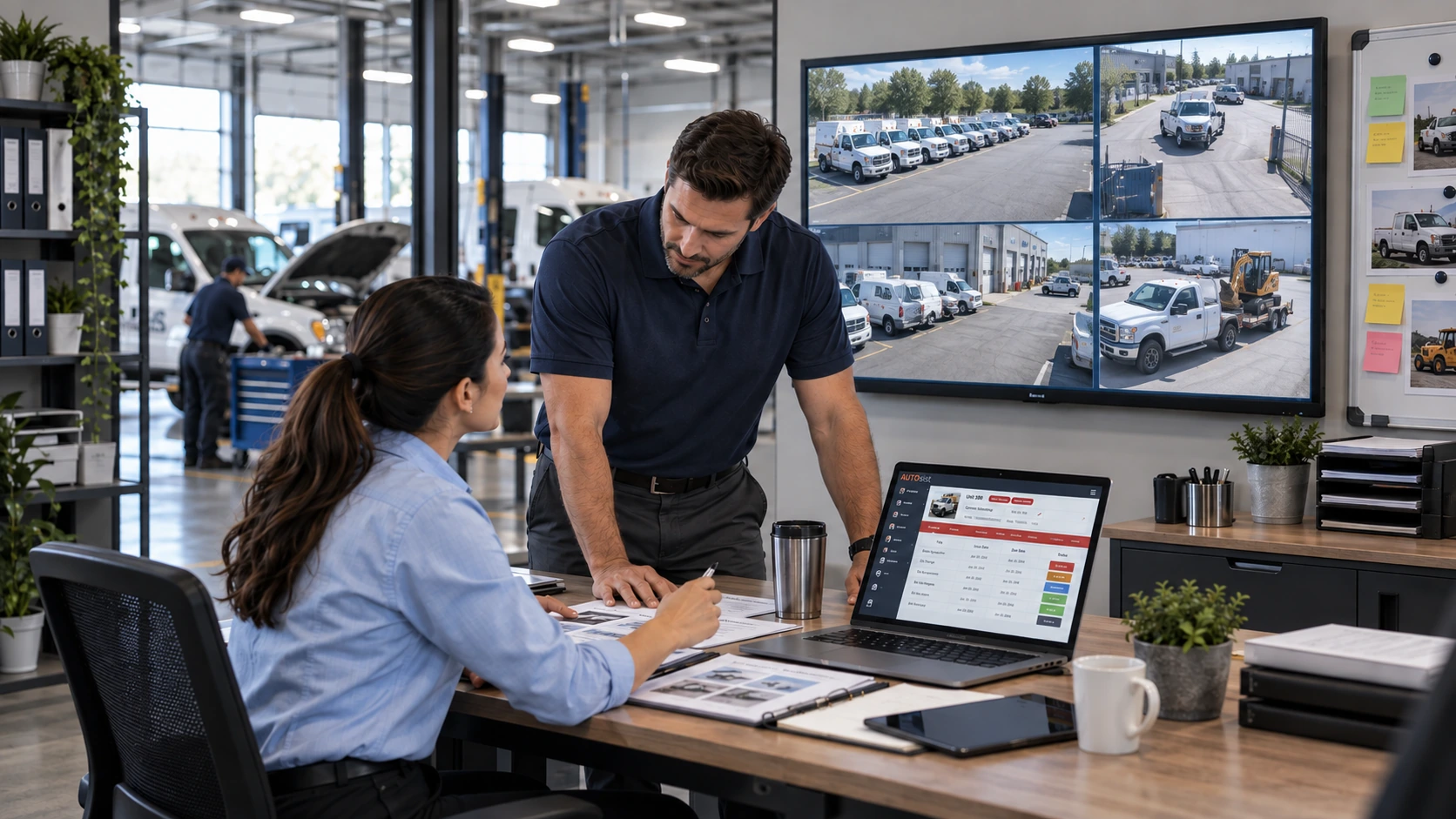

Weekly backlog status board tracking new, aging, ready, and high risk work

Use fleet maintenance work order software to keep status, estimated labor, assignment, and aging in one record instead of scattering the queue across paper, spreadsheets, texts, and memory.

Inspection defects need clear ownership, especially when they affect safety.

A digital vehicle inspection app can keep reported defects connected to the vehicle record and repair decision. Reports, service history, and parts inventory can then expose aging, repeat repairs, and parts hold work without adding separate tracking systems.

Once backlog is visible, work order backlog SLAs and status boards can define ownership, response expectations, and status rules. AUTOsist should support the process as the system of record, not replace weekly discipline.

Frequently Asked Questions

  1. Does every open work order count as fleet maintenance backlog?
    No. Backlog should include identified and approved work that remains incomplete. Unreviewed requests, completed work, and future maintenance that is not yet due should stay outside the backlog.
  2. Should fleet maintenance backlog be measured by work orders or labor hours?
    Labor hours are more useful because one work order may require 20 minutes while another takes several hours. Divide estimated pending labor hours by realistic weekly technician capacity to express backlog in weeks.
  3. How many weeks of fleet maintenance backlog is healthy?
    A common maintenance benchmark is about 2 to 4 weeks of ready work. The age, priority, and safety risk of the work still matter, so the number should never be judged alone.
  4. Is zero fleet maintenance backlog a good target?
    Usually not. Zero backlog can mean defects and follow up work are not being captured, rather than that the fleet has no maintenance needs.
  5. What is the difference between total backlog and ready to schedule backlog?
    Total backlog includes all approved unfinished maintenance. Ready to schedule backlog is the portion with the planning, parts, information, and resources in place so technicians can actually perform the work.
